A Seized Mould on Monday: The Weekend Storage Routine That Was Skipped
Mould Technician - Junior

A Seized Mould on Monday: The Weekend Storage Routine That Was Skipped

A mould seized on Monday morning and cost four hours of downtime because Friday's shutdown routine was skipped once. Dried lubricant and overnight moisture locked the slides solid.

This junior case guide covers the shutdown and start-up routine that protects moulds across the weekend: cleaning, rust prevention, storage and the pre-run checks.

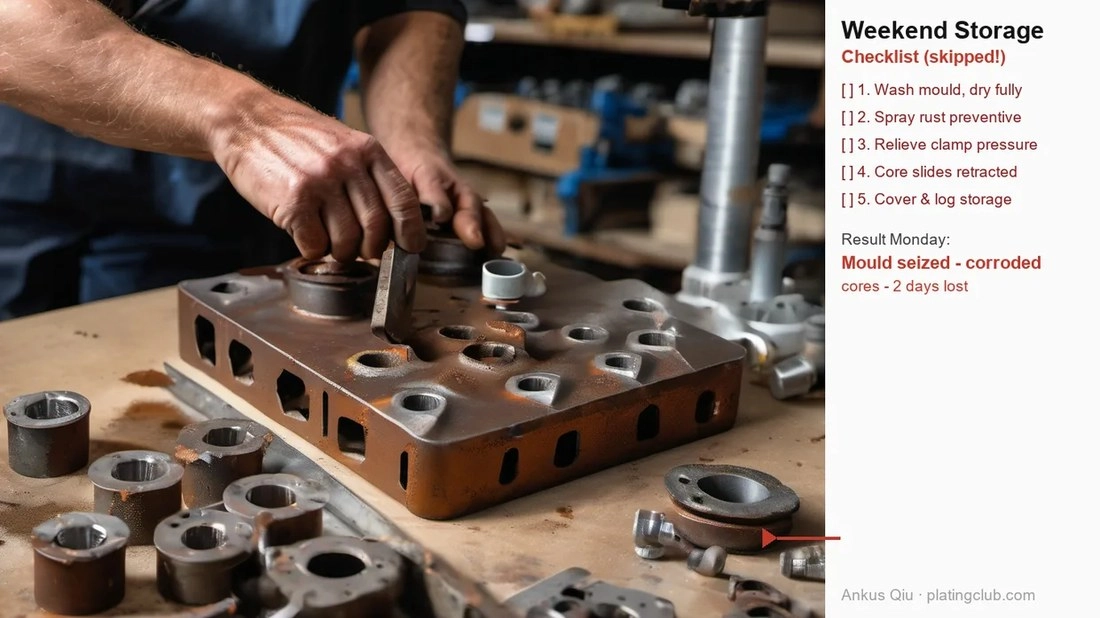

Friday shutdown
Clean, protect, log
Rust preventive
Apply after last shot
Storage
Dry, VCI, below 60% RH
Monday preheat
Die surface 180-220 C
Slide check
Free by hand before clamp
A Seized Mould on Monday: The Weekend Storage Routine That Was Skipped
A Seized Mould on Monday: The Weekend Storage Routine That Was Skipped
Plating production line with tanks and conveyor
Plating production line with tanks and conveyor
Liquid processing machine with tubes and valves on production line
Liquid processing machine with tubes and valves on production line

Common Mistakes and How to Avoid Them

MistakeWhy It HappensPractical Fix
1. Shutdown routine skippedSlides seize by MondayRun the checklist every Friday
2. Mould left dirtyResidue holds moistureClean cavities and slides
3. No rust preventiveCorrosion on polished steelSpray anti-rust after cleaning
4. Stored open to airHumidity reaches the steelStore dry, use VCI
5. No preheat MondayThermal shock and stickingPreheat to 180-220 C first
6. Slides not checkedSeizure found under clampMove slides by hand before run
7. Fresh lube forgottenFirst shots run dryLube slides at every start-up
8. First shots at full speedSticking and damageRun 10 slow shots after start
9. Storage log skippedSame seizure next weekSign the shutdown card

Best Practices

  • Run the shutdown checklist after the last shot Friday
  • Clean and dry every cavity, slide and core
  • Apply rust preventive and store in VCI
  • Preheat the mould before clamping Monday
  • Check slides by hand and lube before the first shot
  • Log shutdown and start-up on the mould card

Implementation Roadmap

StepFrequency
Clean mouldAfter last run, every Friday
Protect surfacesEvery shutdown
Store dryEvery weekend, VCI
PreheatEvery Monday start
Check slides and lubeEvery start-up

Weekend protection flow

  1. Clean - Cavities, slides and cores after the last shot. (Residue holds moisture all weekend.)
  2. Protect - Rust preventive and VCI storage. (Bare polished steel corrodes overnight.)
  3. Preheat - 180-220 C before clamping Monday. (Cold steel shocks and sticks.)
  4. Check - Slides by hand, then 10 slow shots. (A seized slide breaks under clamp.)

One skipped shutdown caused four hours of Monday downtime. | Storage humidity below 60% RH keeps corrosion away.

Mould storage and start data

Reference values for weekend mould care on zinc lines.

ParameterReferenceWhy It Matters
Shutdown cleanAfter last shot FridayRemoves residue that holds moisture
Rust preventiveFull surface sprayAnti-rust oil, not release agent
StorageDry room, VCI, below 60% RHHumidity is the corrosion driver
Monday preheat180-220 C surfacePrevents shock, sticking and cold shut
Slide checkFree by handBefore clamping, always
Lube refreshEvery start-upDried lube locks slides
Slow first shots10 shots at reduced speedProves movement before full cycle

Friday shutdown checklist

StepDetailSign off
CleanCavities, slides, coresDate and name
DryAir blow all surfacesDate and name
ProtectAnti-rust sprayDate and name
StoreVCI, dry rackDate and name
LogShutdown cardDate and name

Case 1 - one skipped shutdown cost four hours

Scenario. A mould for zinc alloy sliders seized on Monday; the Friday shutdown routine had been skipped once because the shift ended early. Dried lubricant and shop moisture locked the slides.

Action. The mould was warmed to 190 C, the stuck slides were freed with heat and gentle tapping, and the full shutdown checklist was made mandatory with a signed card.

Result. No seizure in six months, and Monday downtime for mould causes dropped from four hours to zero.

Case 2 - corrosion in a coastal plant

Scenario. A plant 200 meters from the sea found fine corrosion on cavities every Monday, even on moulds that ran fine on Friday.

Action. VCI bags, a toolroom dehumidifier and a rust-preventive spray step were added to the shutdown routine.

Result. Corrosion marks disappeared, and the toolroom humidity reading became part of the weekly check.

Frequently Asked Questions

Why seize on Monday?

Dried lubricant and moisture act over the weekend; a clean, protected mould stays free.

How long does shutdown take?

Five minutes per mould with a checklist; the seizure it prevents cost four hours.

What should I use for protection?

A proper rust preventive or VCI wrap; release agent dries and does not protect.

How dry must storage be?

Keep the toolroom below 60% RH; coastal plants need a dehumidifier.

Why preheat Monday?

A cold mould shocks the steel and causes sticking and cold shuts in the first shots.

How do I check a slide?

Move it by hand after preheat, before clamping; force under clamp breaks it.

Do I need to lube every start?

Yes - lube dries out; refresh slides at every start-up.

What speed for first shots?

Run about 10 shots at reduced speed to prove slide and ejector movement.

Why sign the card?

A signed log makes the routine visible and stops the 'somebody else' excuse.

What Would You Like to Solve?

Tell us your mould type, storage area and Monday failure pattern, and we can build the shutdown and start-up checklist for your toolroom.

Mould ShopJUNIORA Seized Mould on Monday: The Weekend Storage Routine That Was SkippedToolmakerCooling layout decides cycle time - fix it at design,not on the bench.OperatorEjector travel set wrong bends pins and scratches theparts.QCThe T1 sample decides the tool - check dimensions beforefinal polishing.ManagerShots between services is the number that pays forpreventive work.STEP 1Design ReviewDraft 1-2 degShrink 0.5-0.7%Gate position1STEP 2MachiningTol +-0.02 mmRa 0.4 umCooling circuit2STEP 3Assembly & TrialFit checkT1 samplingEjector travel3STEP 4MaintenancePM at 500k shotsPolish cavitySpare pins4STEP 5HandoverSample reportDrawing packOperator training5!Shrinkage 0.5-0.7%: a cavity cut to nominal size makes undersized parts.COMMON MISTAKES vs WHAT WORKSfrom shop-floor auditsxCut the cavity to nominal sizevAllow 0.5-0.7% shrinkagexPolish the cavity before T1vCheck dimensions first, then polishxFix cooling on the bench latervDesign the cooling layout up front+-0.02 mmToleranceRa 0.4 umSurface5 daysT1 lead timeCASE FROM THE LINECase: a 12% cycle-time gain came from re-cutting one cooling channel.QLQ Surface Treatment | steps, roles, checkpoints, mistakes and a real case
Mould Shop - process board with operator, chemist, QC and management notes, mistakes and a case.

FAQ - A Seized Mould on Monday: The Weekend Storage Routine That Was Skipped

Straight answers from the shop floor. Ask us on WhatsApp if your case is different.

How should finished parts be packed and stored?
Reference values for weekend mould care on zinc lines. Parameter Reference Why It Matters Shutdown clean After last shot Friday Removes residue that holds moisture Rust preventive Full surface spray Anti-rust oil, not release agent Storage Dry room, VCI, below 60% RH Humidity is the corrosion driver Monday preheat 180-220 C surface Prevents shock, sticking and cold shut Slide check Free by hand Before clamping, always Lube.
What safety and environmental controls are required?
Scenario. A mould for zinc alloy sliders seized on Monday; the Friday shutdown routine had been skipped once because the shift ended early. Dried lubricant and shop moisture locked the slides.
What problem does this article solve?
A mould seized on Monday morning and cost four hours of downtime because Friday's shutdown routine was skipped once. Dried lubricant and overnight moisture locked the slides solid.
What does this cost if it is ignored?
Scenario. A mould for zinc alloy sliders seized on Monday; the Friday shutdown routine had been skipped once because the shift ended early. Dried lubricant and shop moisture locked the slides.
What is the practical takeaway for the workshop?
Tell us your mould type, storage area and Monday failure pattern, and we can build the shutdown and start-up checklist for your toolroom. Mould Shop JUNIOR A Seized Mould on Monday: The Weekend Storage Routine That Was Skipped Toolmaker Cooling layout decides cycle time - fix it at design, not on the bench.
Flash That Grew Over Three Weeks: Parting Line Wear Found Before It Became Expensive
Turning a 78 Percent Casting Yield Line into 91 Percent: Scrap Log Review and Machine Cards
